Project Desk · Heavy Lift to Break Bulk

Project Cargo Services

Bulkargo is a project cargo logistics company for heavy-lift and oversized shipments. We find MPP and heavy-lift ships, plan the lift and stowage, and coordinate both ports. Get a quote.

A wind-turbine blade on a red trailer at a break-bulk port, with dock cranes and a moored vessel in the background

What our project cargo services cover

We start with the ship. Project cargo and break bulk travel on a small specialist fleet. MPP ships (multi-purpose ships with their own cranes) carry cranes rated 60 to 350 MT, and two cranes together can lift up to 700 MT. Heavy-lift ships lift 400, 700 or 1,000+ MT in a single piece. Tweendeckers have a second deck inside the hold, which makes stowage flexible. Open-hatch bulkers take long pieces that cannot be split, and general cargo ships carry break-bulk programmes. The ship has to fit the cargo before we talk about price. We check crane SWL (safe working load), hold size, tweendeck strength, weather-deck class and how much weight the tanktop (the floor of the hold) can take.

Two kinds of cargo use this fleet, and neither moves in containers or as dry bulk.

Project cargo means pieces that are too big, too heavy or too awkwardly shaped for a container. Many are also too big for an ordinary general cargo ship. Typical pieces are wind turbine blades and nacelles, transformers, port cranes, industrial plant modules, prefab building sections, heavy machinery such as excavators and crushers, pressure vessels and bridge sections. We treat each piece as an engineering job. The lift points, centre of gravity, sea-fastening and air draft all have to check out before the piece goes on board.

Break bulk travels as separate units on the same ships: steel coils and plate, sawn lumber, bagged cargo (urea, cement, fertiliser), drummed cargo (chemicals, lubricants, packed bitumen) and packaged machinery. Each unit is smaller than a project piece. It still needs a stowage plan, dunnage and lashings. Our break-bulk cargo guide explains how this cargo is handled.

Project cargo and break bulk are part of Bulkargo’s wider ship brokering work. We have fixed project cargo and machinery alongside our dry-bulk business since 2022. The work covers lifting plans across several load ports, heavy-lift crane fixtures, and lashing and securing plans signed off by the master and the surveyor. It also covers the inland coordination that often comes at each end of a project voyage.

Cargoes we cover

Each industry ships its own kind of cargo. Wind parts are huge and light for their length. Blades need cradles and careful handling on the weather deck. A nacelle puts all its weight on a single lift point. Mining cargo is the opposite. Excavator bodies, crusher housings and mill liners pack a lot of weight into short, awkward shapes. Construction and EPC clients ship prefab modules and pressure vessels, and for these the engineering paperwork matters as much as the lift. Infrastructure projects bring port cranes, bridge sections and long pipe that hangs over the end. Most projects mix two or three of these.

Energy & Renewables

Wind tower sections, nacelles, hubs and blades. Transformers, generators and solar trackers. Battery storage units and HVDC components.

Construction & EPC

Prefab building modules, steel bridge sections, pressure vessels, large tanks, boilers and structural steel.

Mining & Heavy Industry

Excavators, draglines, crushers, conveyor systems, mill parts, refinery modules, and dragline buckets and booms.

Infrastructure

Port cranes, ship-to-shore gantry cranes, rail equipment, locomotives, large-diameter pipe and large generators for substations.

Industrial Modules

Process modules for refineries, LNG terminal modules, petrochemical plant skids and modular building units.

Break Bulk

Steel coils and plate, bagged and drummed cargo, palletised industrial goods, lumber and project pipe.

Vessel sourcing

A small specialist fleet

Most of the job in project brokering is knowing which ship will pass your load port empty in three weeks.

  • Multi-purpose ships (MPP) with their own cranes: 8,000 to 25,000 DWT, SWL 60 to 350 MT per crane, and up to 700 MT with two cranes lifting together
  • Heavy-lift ships that lift 400, 700 or 1,000+ MT for single project pieces
  • Tweendeckers for flexible stowage when you ship several cargo grades
  • Open-hatch bulkers for long pieces that cannot be split and must be loaded from above
  • General cargo ships for break-bulk programmes that do not need heavy lift

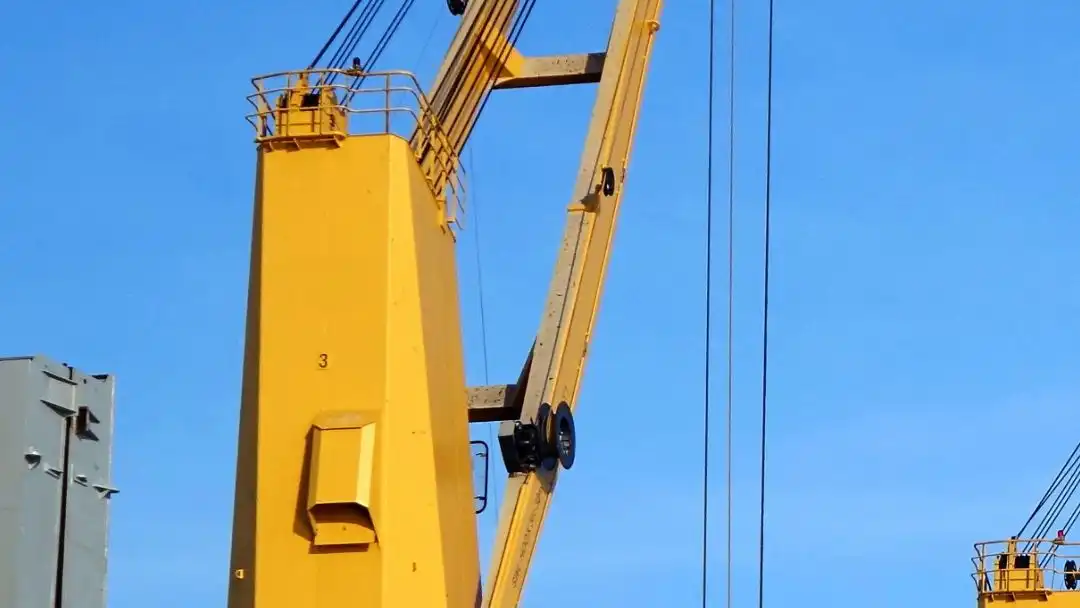

A yellow heavy-lift deck crane on a project-cargo vessel against a clear sky

Why project cargo needs a specialist broker

General freight forwarders often struggle with project cargo. The hard part comes before the price: the ship’s technical limits. Nobody can negotiate those limits. Get one of them wrong and the cargo cannot be loaded when the ship arrives.

The master and chief officer draw up the stowage plan. The cargo owner or its insurer often hires a Marine Warranty Surveyor (MWS) as well. The MWS checks the sea-fastening calculations, the lashing, the ship’s stability and the planned weather route. The surveyor stands on the quay for the lift of a heavy single piece and signs off the securing before the ship sails. A good broker answers the surveyor’s questions before the ship is firmly nominated.

Securing and lashing are engineering work. The lashing plan decides whether the cargo arrives intact. It draws on how the weight spreads across the deck plating, point loads on the tanktop, the choice of dunnage and the weather route. Loading at several ports adds to the work. Modules may come from two or three different suppliers. The ship then has to be positioned and stowed so each port adds cargo without disturbing what is already on board.

We plan the lift while we choose the ship. Shore cranes are usually the cheaper option where the port has them and they are rated for the heaviest piece. Otherwise we fix a heavy-lift ship with its own cranes. Sometimes two booms work together in a tandem lift, with a lifting beam between them. A floating crane or jack-up rig may come alongside for the hardest pieces. Each option changes the price, the schedule and the technical risk. The cargo list alone rarely tells you which one is right.

Put cargo on the wrong ship and it may not load at all, or it has to be lifted twice at extra cost. You choose the ship first. The price comes after.

On project cargo brokerage

How we fix a project voyage

A project fixture takes time. The fleet is small, every cargo is one of a kind, and the work runs from reviewing drawings to inland delivery at each end. Expect four to eight weeks from inquiry to sailing, for predictable reasons. Few heavy-lift ships trade on any one route. The carrier has to clear the cargo technically in advance. Cranes and berths have to be booked at both ports. Road or rail legs need route surveys. Loading at several ports, or a tight weather window, can push this to ten or twelve weeks. Here is the sequence we run from inquiry to discharge.

  1. 01

    Cargo assessment

    We look at the size, weight and centre of gravity of each piece, where and how it is lifted, how sensitive it is to weather or movement, and the total stowage volume.

    You provide
    Drawings, cargo list, dimensions
    We handle
    Technical review, out-of-gauge (OOG) check
  2. 02

    Lift assessment

    We check the crane SWL for the heaviest single piece and whether it needs a tandem lift. We choose a heavy-lift ship if the shore cranes cannot do the job. We also check quay strength and air draft.

    We handle
    Lift plan, ship cranes compared with shore cranes
  3. 03

    Choosing the ship

    We choose between MPP, heavy-lift and tweendecker. We compare hold size with cargo size, and we check whether deck cargo is allowed, crane reach and SWL, draft, age and trading pattern.

    We handle
    A shortlist of two to four ships
  4. 04

    Stowage planning

    We work with the master and chief officer on the stowage and securing plan. That covers lashing, sea-fastening to the deck or hold plating, and stability calculations.

    We handle
    Stowage plan, MWS brought in if needed
  5. 05

    Port & inland coordination

    We check and book cranes at both ports and confirm berth limits. We also handle customs for oversized cargo, route surveys for the inland leg, and permits.

    We handle
    Port liaison, inland routing, permits
  6. 06

    Documentation & voyage

    We handle the charter party (Heavycon, Projectcon), the bill of lading with cargo description and marks, MWS approval and insurance certificates. We follow the voyage through discharge.

    We handle
    Charter party review, post-fixture support, dispute handling

Our work continues after the ship sails. We keep in touch with the MWS surveyor during the voyage. We watch the weather route where the carrier or insurer requires a set track. We also prepare for arrival at the discharge port. That means shore cranes or the ship’s own cranes for discharge, the receiving berth (arranged with the agent), trailers or modular transporters for the inland leg, and customs papers for oversized cargo. Out-of-gauge cargo often needs permits, escorts and route surveys, and the paperwork must be ready before the ship arrives. We stay on the job through discharge, demobilisation and final delivery. Send us the cargo list and ports and we will start the technical work.

Recent project: five sailings to Linden, Guyana

We moved about 17,000 tonnes of bagged and drummed road-building materials from Colombia to Linden, Guyana, in five sailings on geared ships (ships with their own cranes). Cement came from Barranquilla, quicklime from Cartagena and asphalt products from Barrancabermeja. We consolidated all of it at Cartagena before loading. Our desk designed the lifting gear. We fixed a ship sized for the old Demerara bridge and the river’s tidal draft. Read the Linden case study.

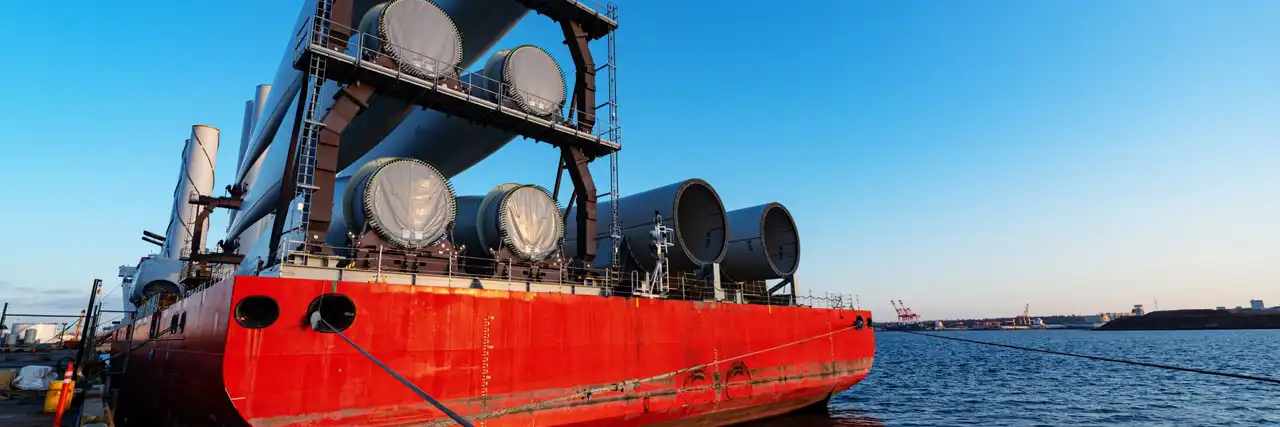

A ship loaded with large cylindrical project-cargo units moored at a harbour

What clients ask first

What is the heaviest single piece you can ship?
A standard MPP ship can lift about 350 MT in one piece with its own cranes. For heavier pieces we move to a dedicated heavy-lift ship with 700 or 1,000+ MT capacity. The specialist fleet (Combi Lift, BigLift, SAL, COSCO heavy-lift class) can lift 2,000 MT and more. Above that weight, the shore handling sets the limit.
Can you handle the shipment door to door?
Our project desk fixes the sea leg and coordinates the work at both ports. We work with established project logistics partners for the inland transport at each end. We can quote a full door-to-door job on request.
How much lead time do you need?
A standard project fixture takes 4 to 8 weeks from your inquiry to the ship sailing. Allow 10 to 12 weeks for several load ports or complex stowage in a busy market. A straightforward break-bulk shipment with an open laycan takes 2 to 3 weeks.
Do you ship containers or RoRo?
No. We do not broker container freight or scheduled RoRo. Some wheeled equipment overlaps with project cargo, and for that we can advise you on RoRo line operators.
Get a Quote

Ready to fix?

Tell us about your cargo. A broker will respond the same business day with an initial market read and next steps.

Cargoes we have fixed since 2022

  • Cement
  • Quicklime
  • Bitumen
  • Project cargo
  • Machinery
  • Mining ores and earths
